IoT Product Development Process: From Idea to Production
Quick answer: The IoT product development process runs through seven stages — concept and discovery, hardware design, firmware, backend and cloud, app or dashboard, testing and certification, and manufacturing at scale. End to end, a first production run typically takes 9–18 months and rarely fewer than four. The stages overlap rather than run in a straight line, and most projects don't fail inside a stage — they fail at the seams between hardware and software, which is exactly why one integrated team matters.
If you're planning a connected product, "how is this actually built?" is the right question to ask before you spend a cent. Below is the full lifecycle — what happens at each stage, what you need to decide, roughly how long it takes, and where the expensive mistakes hide.
What is the IoT product development process?
An IoT product is not one product — it's four stacked on top of each other: hardware, firmware, cloud, and an app or dashboard, tied together by a connectivity choice. The development process is the sequence of decisions and validation gates that carries all four from an idea to units you can ship and support.
The important word is system. A sensor that works on your desk is not a product; a product is thousands of devices that connect reliably, update securely, and keep reporting for years in places you can't reach. That system view is what separates a demo from something you can sell.
The 7 stages of IoT product development
Here is the lifecycle at a glance. Timelines assume a moderately complex, battery-powered connected product; simpler builds move faster, regulated or novel hardware slower.
| # | Stage | Key decision to make | Rough timeline |
|---|---|---|---|
| 1 | Concept & discovery | Is the use case and unit economics real? | 2–6 weeks |
| 2 | Hardware design | MCU, sensors, power, connectivity | 6–14 weeks |
| 3 | Firmware | RTOS vs bare metal, OTA strategy | Runs in parallel from Stage 2 |
| 4 | Backend & cloud | Device management, data model, security | 6–12 weeks |
| 5 | App & dashboard | Web, native, or both | 6–12 weeks |
| 6 | Testing & certification | CE/FCC, security, field pilots | 6–12 weeks |
| 7 | Manufacturing & scale | Contract manufacturer, EVT/DVT/PVT | 3–6 months |

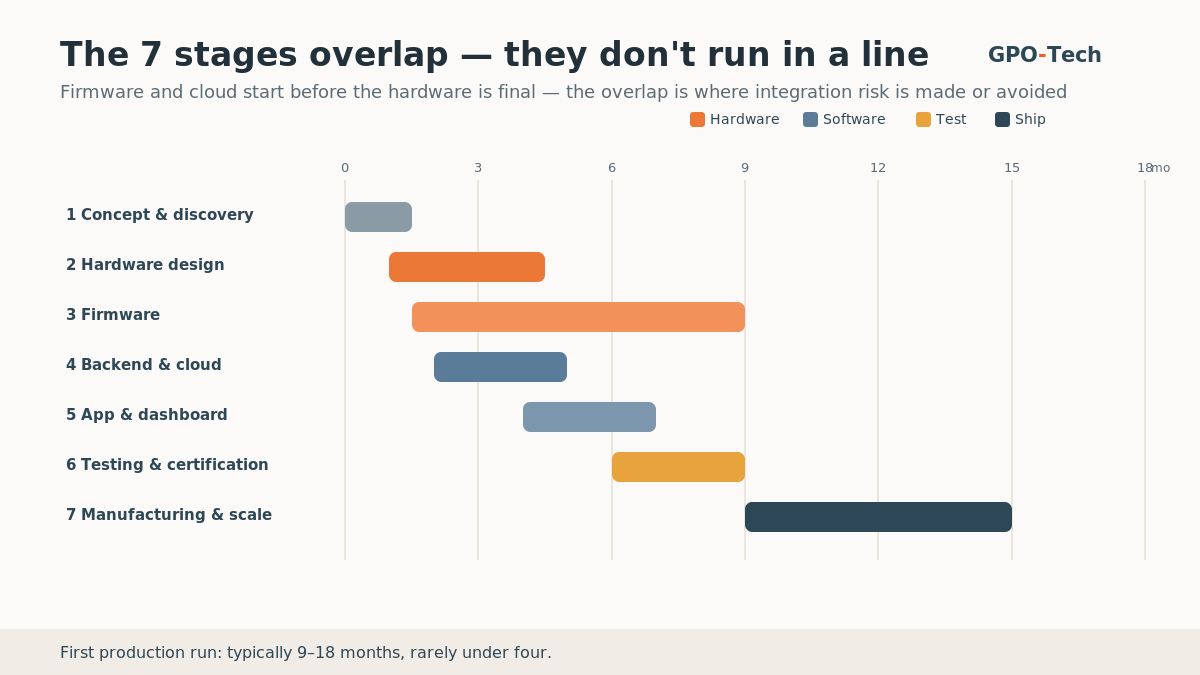

Notice that the stages overlap. Firmware, cloud and app work start well before the hardware is final — and that overlap is where integration risk is either created or avoided.
A closer look at each stage
Stage 1 — Concept & discovery. Define the problem, the user, and the numbers. What does the device sense, where does it live, how does it connect, and does the bill of materials leave room for a margin? Deliverable: a validated brief and a rough architecture. Decide here whether the idea is worth building before hardware locks anything in.
Stage 2 — Hardware design. Schematic, PCB layout, component selection (a microcontroller such as an ESP32, STM32 or nRF family), power budget, and enclosure. The big call is connectivity — Wi-Fi, BLE, cellular, or an LPWAN like LoRaWAN or NB-IoT — because it shapes cost, range and battery life for the life of the product.
Stage 3 — Firmware. The embedded code that makes the device sense, sleep, reconnect and update itself in the field. This is where over-the-air (OTA) updates, power management and security are won or lost. Firmware should start alongside hardware, not after it — designing a board without firmware input is the classic source of late surprises.
Stage 4 — Backend & cloud. Data ingestion, storage, device provisioning and management, and APIs. Decide your data model and security model early; a fleet you can't monitor, update or revoke credentials on is a liability, not an asset.
Stage 5 — App & dashboard. The part users actually see — a mobile app, a web dashboard, or both. Scope this to the one job the product exists to do; polish can come after real users confirm the core loop works.
Stage 6 — Testing & certification. Functional, reliability and field testing, plus regulatory certification (CE/RED in the EU, FCC in the US) and security hardening. Build validation batches: in our experience an early engineering batch can see a meaningful share of units fail, and that is the point — you want failures on the bench, not in the field.
Stage 7 — Manufacturing & scale. Design for manufacturing, a contract manufacturer, and the EVT → DVT → PVT gates that take you from working prototypes to a repeatable production line. The last gate, PVT, is usually a small pilot (often 5–10% of the first run) to confirm yield before you commit to volume.
Why do most IoT products fail at the seams?
Because IoT is a system of systems, and the risk lives between the parts, not inside them. If hardware is designed without firmware and cloud requirements in mind, the gaps surface late — when a board can't hit the power budget the firmware needs, when the radio choice can't carry the data model, or when a certification rule forces a redesign. A linear, thrown-over-the-wall workflow almost guarantees these collisions.
Two things make the seams expensive:
- Cost escalates as you move downstream. A flaw that costs about $1,000 to fix in a prototype can cost $10,000 or more once it's in tooling and production — roughly a 10x jump.
- Two vendors means two blind spots. When electronics and software are split across separate suppliers, nobody owns the integration, and the finger-pointing starts exactly where the product is weakest.
This is the case for one integrated team that carries hardware, firmware, cloud and app together — the seams become internal handoffs instead of contractual gaps. It's also the single most useful filter when you choose an IoT development company.
Not sure where your project's risk sits? Tell us what the device does and how far along you are — we'll map it to these stages and flag the seams. Ask our engineers →
How long does it take — and what does certification add?
As a rule of thumb: a proof of concept in 4–8 weeks, a working prototype in 2–4 months, and an end-to-end MVP in 4–9 months. A production-ready first run usually lands at 9–18 months once manufacturing and certification are included.

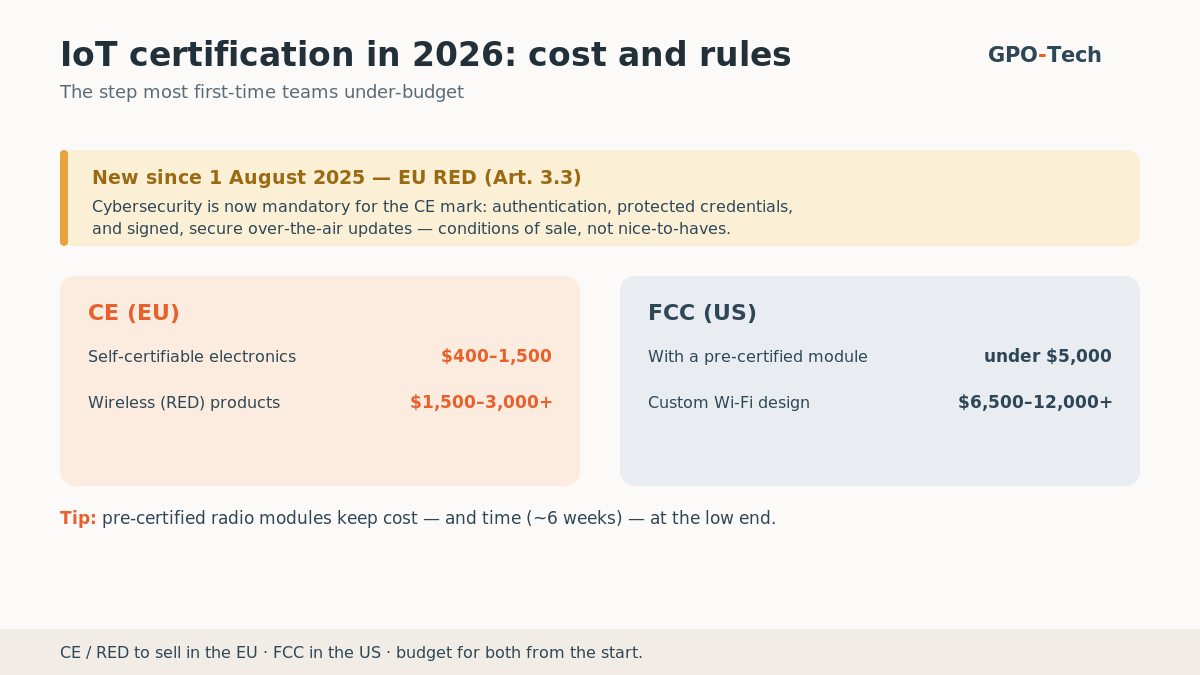

Certification is the step most first-time teams under-budget, and the rules moved recently. Since 1 August 2025, the EU Radio Equipment Directive (RED Article 3.3) makes cybersecurity mandatory for connected devices — authentication, protected credentials and secure, signed updates are now conditions of the CE mark, not nice-to-haves. Budget accordingly:
- CE (EU): roughly $400–$1,500 for self-certifiable electronics; $1,500–$3,000+ for wireless (RED) products before lab time.
- FCC (US): under $5,000 with a pre-certified radio module; $6,500–$12,000+ for a custom Wi-Fi design.
- Time: modular radio certification often runs about six weeks when your paperwork is in order.
Using pre-certified radio modules is the most reliable way to keep certification at the low end of these ranges. For a full cost breakdown by component and stage, see what it costs to build an IoT device.
How do you reduce risk across the lifecycle?
- Start with discovery, not a PCB. A short paid discovery to lock the use case and architecture is the cheapest de-risking you can buy.
- Prototype before you commit. Fixes are an order of magnitude cheaper on the bench than in tooling.
- Ship an MVP, not the dream. Scope to one core use case and validate demand first — that's the whole point of a hardware/IoT MVP.
- Design hardware and firmware together. The board and the code should be specified in the same room.
- Reuse proven platforms. Device management, OTA and dashboards don't need to be reinvented per project.
- Keep one team across the seams. Integration is a feature, not a hand-off.
FAQ
What are the stages of IoT product development?
Seven: concept and discovery, hardware design, firmware, backend and cloud, app or dashboard, testing and certification, and manufacturing at scale. In practice they overlap — software and firmware begin while the hardware is still being finalized.
How long does it take to build an IoT product?
A proof of concept takes 4–8 weeks, a prototype 2–4 months, and an end-to-end MVP 4–9 months. A production-ready first run usually takes 9–18 months once certification and manufacturing are included.
What is the hardest part of IoT development?
Integration. Most projects don't fail inside a single stage; they fail at the seams between hardware, firmware and cloud — which is why designing them together, under one team, matters more than any single component choice.

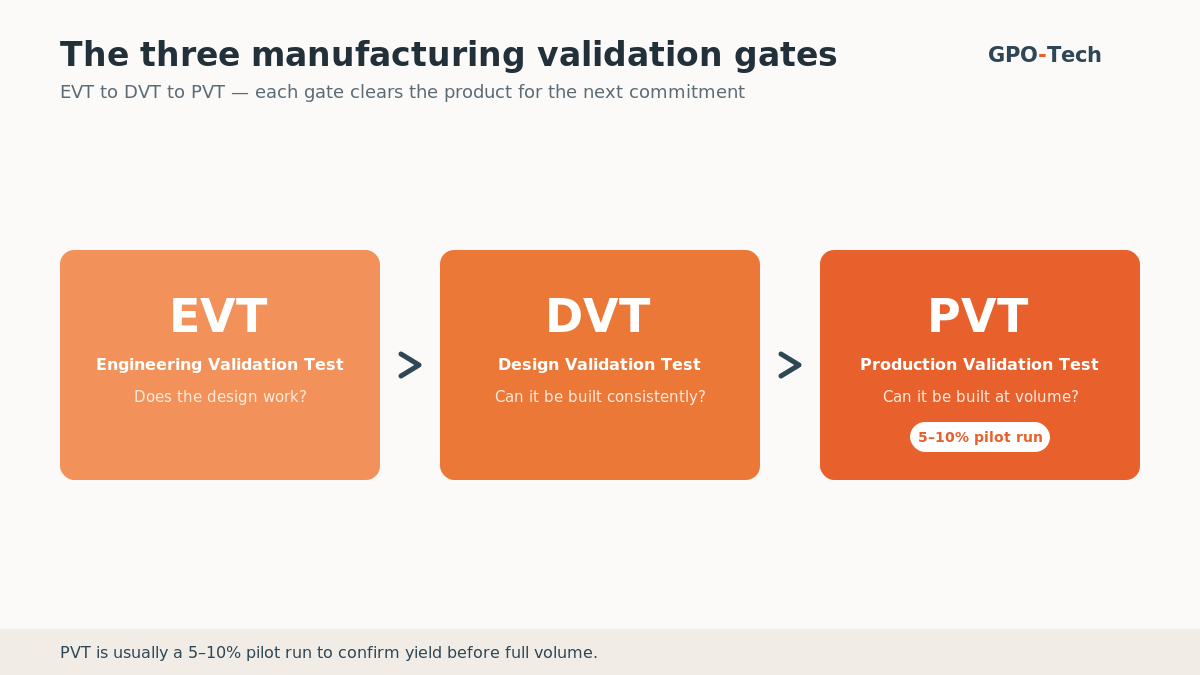

What do EVT, DVT and PVT mean?
They are the three manufacturing validation gates: Engineering Validation Test (does the design work?), Design Validation Test (can it be built consistently?), and Production Validation Test (can it be built at volume?). PVT is usually a small pilot run before full production.
Do I need CE or FCC certification for an IoT device?
Yes — CE/RED to sell in the EU, FCC in the US. Since August 2025, CE/RED also requires built-in cybersecurity (authentication, secure updates, credential protection). Using pre-certified radio modules keeps both cost and timeline down.
Can one company build the whole IoT product?
Yes, and it's usually the lower-risk path. A team that owns hardware, firmware, cloud and app removes the integration gaps that appear when electronics and software are split across separate vendors.
Get a plan for your product
Every product moves through these seven stages — the difference between a smooth build and an expensive one is how well the seams between them are managed. The fastest way to see your own path is a short conversation.
Tell us what you're building and where you are, and we'll map it to a realistic stage plan, timeline and cost. Request a quote → or book a call with our engineers →.
GPO-Tech designs and builds connected products end to end — electronics, firmware, cloud and apps — from one team in Tallinn, Estonia.
